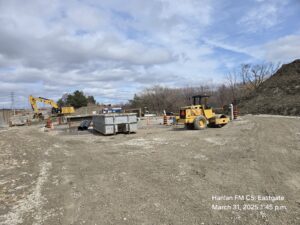

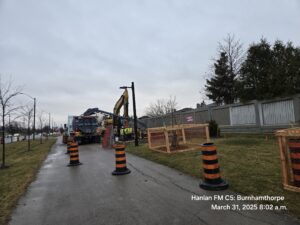

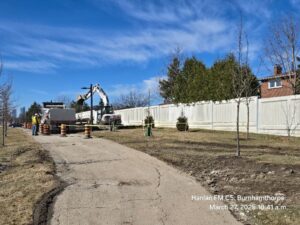

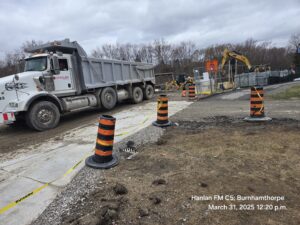

UPDATE: April 1, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
- Finished excavation and removal of the blockage for the drilling work in the boulevard near Corbet and Burnhamthorpe
- Removed soil ahead of work in the park
——————————————————————————————————————————————————
UPDATE: March 28, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
- Prepped the site for shoring system installation scheduled for next week
- Continued to excavate for concrete barrier removals
- Repaired the mud mat and access road at compound entrance and across the multi-use trail
Eastgate:
- Atlas (subcontractor) set up treatment system for the groundwater and took samples
——————————————————————————————————————————————————
UPDATE: March 25, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
- Continued to expose and cut into existing feedermain
- Installed 1 of the 2 temporary bulkheads ahead of pipe removal work
Eastgate:
- Continued to excavate for concrete barrier removals
——————————————————————————————————————————————————

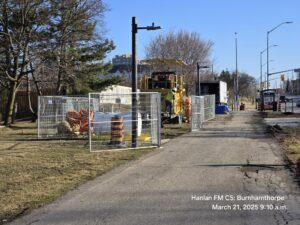

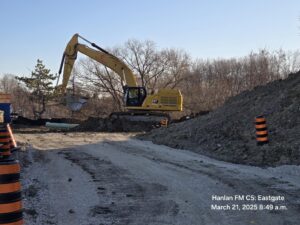

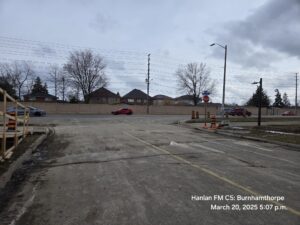

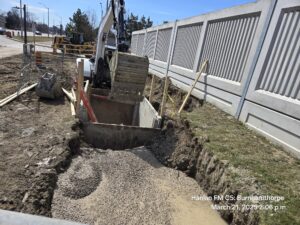

UPDATE: March 21, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
• Demobilized after completing the drilling work and cleaned up the area
• Reopened Corbet Drive from Burnhamthorpe Road East to Ibis Court
• Broke into existing feedermain to begin removing water
Eastgate:
• Continued excavation for concrete barrier removals
——————————————————————————————————-

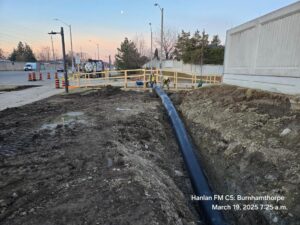

UPDATE: March 19, 2025

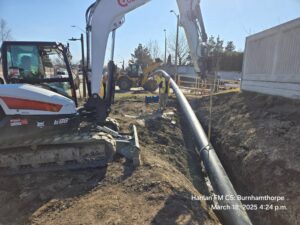

Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
• Completed drilling work
• Started to remove sections of the existing pipe to start excavation and shoring for building the interconnect chamber
Eastgate:
• Finish excavation and set up ahead of water pumping and locating existing pipe joints
——————————————————————————————————-

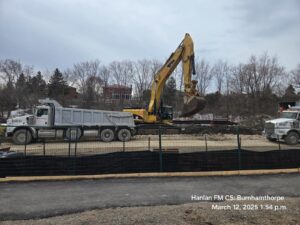

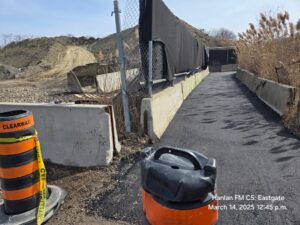

UPDATE: March 14, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:

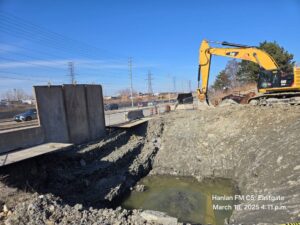

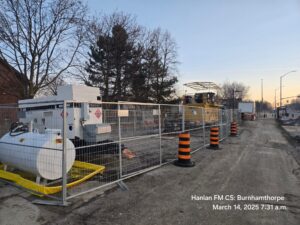

• Continued drilling work along Burnhamthorpe Road
• Finished excavation over existing pipe and installed shoring inside the park compound
Eastgate:
• Excavated and installed shoring for removal of underground concrete barrier over existing feedermain
• Completed repair of existing temporary pathway behind compound ahead of sidewalk closure for pedestrian detour

——————————————————————————————————-

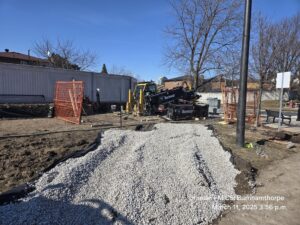

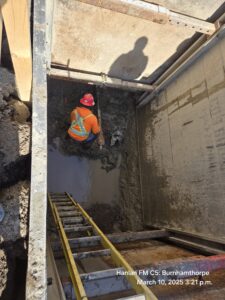

UPDATE: March 11, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
• Continued drilling for the new 400mm watermain
Eastgate:
• General maintenance of site and equipment

——————————————————————————————————-

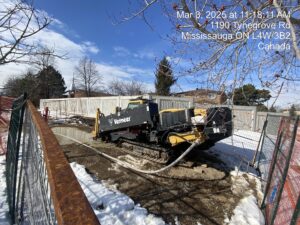

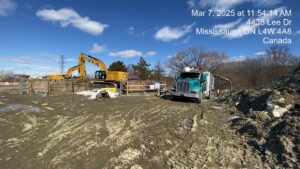

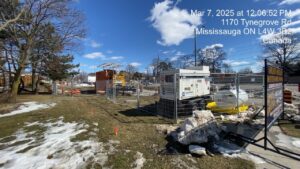

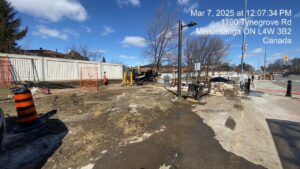

UPDATE: March 7, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
• Continued drilling for the watermain
Eastgate:
• Installed the remaining monitoring points ahead of excavation work

——————————————————————————————————-

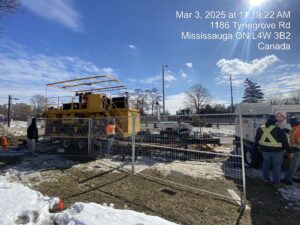

UPDATE: March 5, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
• Finished mobilizational and set up of the horizontal drilling work equipment
• Commenced drilling for the watermain installation in the boulevard
Eastgate:
• Completed mobilization for dewatering system equipment
• Began testing pumps and pipes/hoses
• Took water samples for discharging groundwater to the sewers

————————————————————————————————————————————————————————————————

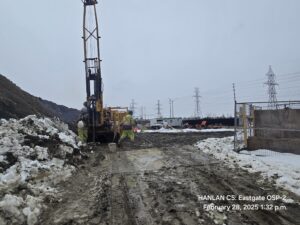

UPDATE: February 28, 2025
Here are the construction activities we have been working on since the last update:
Burnhamthorpe:
• Set up laydown areas in preparation for horizontal drilling work
• Equipment for the drilling was delivered
• Continued installation of monitoring points ahead of construction
• Installed mud mats (large heavy-duty mats) and temporary access roads
Eastgate:
• Atlas mobilized equipment for upcoming dewatering work
• Installed mud mats and temporary access roads for trucks
• Began installation of monitoring points ahead of construction

——————————————————————————————————-

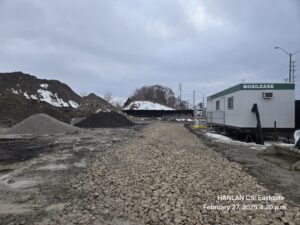

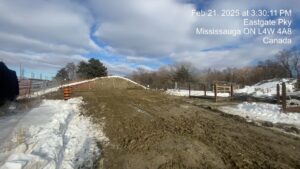

UPDATE: February 24, 2025
Here are the construction activities we have been working on since the last update:
• Continuing investigative work on existing Hanlan Feedermain
• Continuing working on administrative duties with submissions, permits and approvals
• General snow maintenance and removal from work compounds
• Installation of fast fencing for upcoming HDD area
————————————————————————————————————————————————————————————————

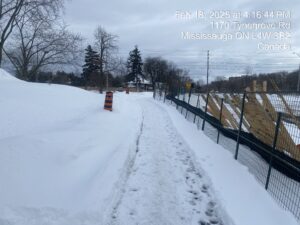

UPDATE: February 12, 2025
Here are the construction activities we have been working on since the last update:
• Continuing investigative work on existing Hanlan Feedermain
• Continuing working on administrative duties with submissions, permits and approvals
• General snow maintenance and removal from work compounds
• Commenced the HDD exit shaft excavation on the Burnhamthorpe boulevard

————————————————————————————————————————————————————————————————
UPDATE: February 12, 2025
Here are the construction activities we have been working on since the last update:
• Continuing investigative work on existing Hanlan Feedermain
• Continuing working on administrative duties with submissions, permits and approvals
• Completed pre-condition surveys of local residences and buildings
• Preparing to install/remove signs and clearing ice and snow from the temporary path
• Preparing for the upcoming snowstorm

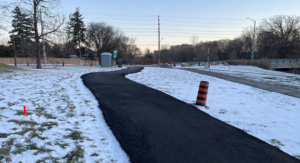

• The temporary path will be opening this Friday, February 14th at 10:00 a.m.
————————————————————————————————————————————————————————————————
UPDATE: February 7, 2025
Here are the construction activities Staff have been working on since the last update on February 5, 2025:
• Continuing investigative work on existing Hanlan Feedermain
• Continuing working on administrative duties with submissions, permits and approvals
• Continued building the pedestrian elevated walkway for future work at Burnhamthorpe and Corbet
• Continued pre-condition surveys of local residences and buildings
• We are planning to open the temporary path next Thursday, February 13th
————————————————————————————————————————————————————————————————
UPDATE: February 5, 2025
Burnhamthorpe Compound:
• Resurfaced the temporary path to make the slopes safer for pedestrians
• Commenced building the pedestrian elevated walkway for future work at Burnhamthorpe and Corbet
• Continued pre-condition surveys of local residences and buildings
————————————————————————————————————————————————————————————————

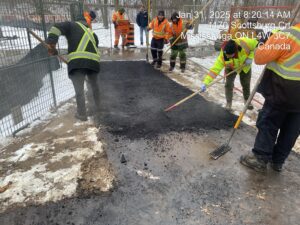

UPDATE: January 31, 2025
Burnhamthorpe Compound:
• Excavated and installed utility monitoring points for vibration monitoring when construction starts
• Improved temporary asphalt path for Applewood Hills Trail ahead of opening (week of February 10th)
• Continued pre-condition surveys of local residences and buildings (photos of private properties) by subcontractor
Eastgate Compound:
• Continued daylighting existing watermain to confirm exact location
—————————————————————————————————–UPDATE: January 28, 2025
Please find the updated notice from the Region of Peel in regard to this project.
——————————————————————————————————-

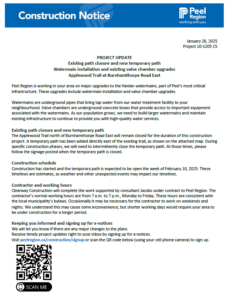

UPDATE: January 27, 2025
As the Region of Peel has now progressed to mobilizing phase 1 construction for the Hanlan C5 Compound on the north side of Burnhamthorpe Rd. @ Applewood Hills Trail, I wanted to share that the Applewood Hills port-o-let has been moved to the new agreed upon location at Bloor St. This placement will continue to serve the Applewood Hills trail users while the Regional construction project is completed at Burnhamthorpe.
——————————————————————————————————-
UPDATE: January 24th, 2025
Here are the construction activities we have been working on since my last update:
• Subcontractor (Frontop) has been on site checking noise and monitoring equipment (checking logs and batteries) and began dropping off notices for pre-condition surveys
• Frontop began taking pictures of buildings for the pre-condition surveys
• Contractor (Clearway) commenced chamber investigations in the Burnhamthorpe compound and surrounding area

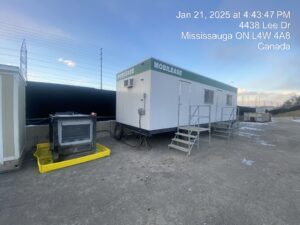

• Set up site office trailer at the Eastgate compound
• Contractor reinforced privacy wooden hoarding behind 1170 Scottsburg Court
——————————————————————————————————-

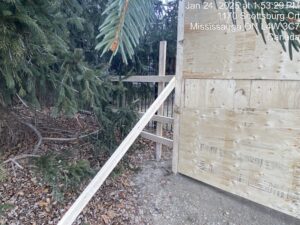

UPDATE: January 20th, 2025
Below are the construction activities staff have been working on since the last update on January 15th, 2025.
Burnhamthorpe compound last week:
• Installed wooden fencing for privacy for the residents at 1170 Scottsburg Court, which was completed by the end of the day on Friday, January 17th
• Cleaned up from the test pits completed earlier last week
Burnhamthorpe compound today:

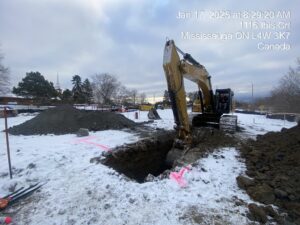

• The Contractor began laying out the watermain pipes and setting up the machine for the drilling work in the boulevard
• Decommissioning some monitoring wells around the compound
The Applewood trail is currently closed at the north side of Burnhamthorpe with a detour and signage in place, but staff are also working on a temporary trail that we intend to open up in February so that we can get rid of the detour. The temporary trail will be opened for most of the duration of this project, but staff will have to close and reinstate the detour periodically as needed for the construction of this project.
——————————————————————————————————-

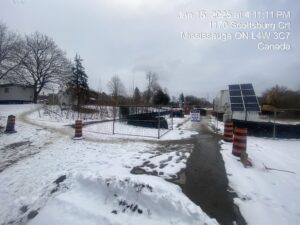

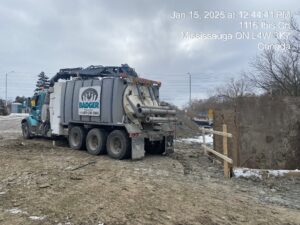

UPDATE: January 15th, 2025
This is the work that has been completed so far this week:
1. Burnhamthorpe compound:
• Crew are completing test pits and daylighting in the park to verify the existing utilities ahead of upcoming chamber and CPP installation
• Since the project has started they have installed the project signs, fencing and tree protection
• Applewood Trail has been closed as per the approved plans with detour signs installed
• Temporary path is currently closed with fencing and barrels
• Temporary path will be open for use once all signage and notification has been completed

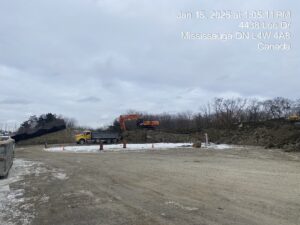

2. Eastgate compound:
• Crew is working on earth works to set up compound ahead of the chamber and CPP installation

——————————————————————————————————-
UPDATE- January 13th, 2025
Please be advised that the attached tree permit has been approved to remove nine trees and prune one more at the Region of Peel Hanlan C5 project located at Applewood Hills Park and Burnhamthorpe. The removals are necessary to replace a watermain chamber within the park, and also to accommodate boring pits/machinery east and west of the site on Burnhamthorpe. Compensation amounts are being received from the Region for tree replacements, and these will take place once the project is complete.
Please keep in mind that this situation is a result of the ongoing replacement of the watermain chamber, which is necessary to ensure the long-term integrity and functionality of the water supply system.
———————————————————————————————————————————————————————————————————————————————————————————————–

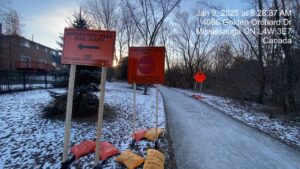

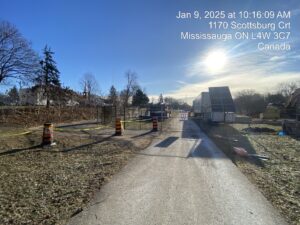

UPDATE- January 9th, 2025
The work performed on site, as of today, is as follows.
- Commenced the placement of the hoarding/fencing around our compound
- Placement of detour signage along the detour route.
- Temporarily closed both the existing path and the temporary walkway to mitigate general public proximity to active work while installing the perimeter fencing.
Further updates will continue as work progresses.
——————————————————————————————————————————————————
Update: January 2025
Site Conditions and Temporary Walkway
In regard to the site conditions and walkway concerns, we have visited the site and have provided a response below, with the support of photos from this late this afternoon and from December 19, when the walkway was initially constructed.

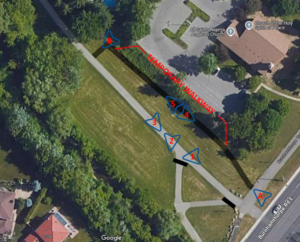

Below is an aerial image of the park with the location and direction of the photos contained below.

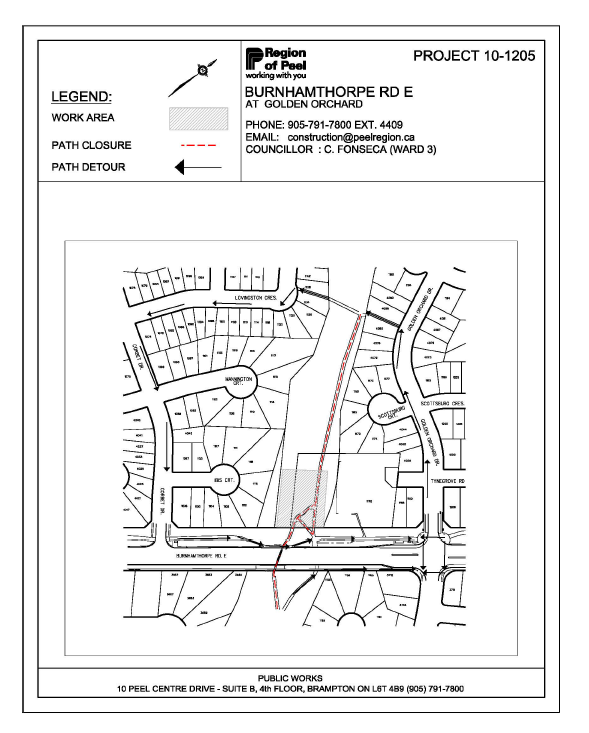

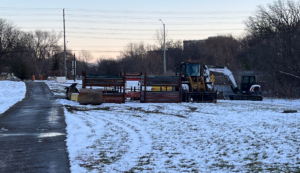

The photos at Location 1 to 3 show the equipment and materials referenced in the residents concerns. It is off the existing multi-use trail, and neatly placed in a common area.
Location 1
Location 2
Location 3
The photo at Location 4 supports the comments provided by the resident and we agree that a member of the public has relocated the barrels that were erected as a temporary deterrent at the new walkway and Burnhamthorpe. The photo at Location A was taken when the temporary walkway was built. The barrels and deterrent have been removed. Our vendor will be on site tomorrow (Friday) to re-erect a deterrent at the south end of the temporary walkway.
The photo at Location B and Location 5 shows that the north end of the temporary walkway still has the barrels and deterrent in place. Our vendor will validate its state and may look at installing something a little more sturdy/difficult to purposely relocate.
Location 4: (Taken December 19)
Location 5
Location B (Taken December 19)
The site was visited by our contractor and the barrels were re-erected. Staff will be erecting a more robust deterrent from using the temporary walkway until such time as the walkway becomes the main path.
——————————————————————————————————————————————————
Update: December 2024
Current/Planned Projects
- Hanlan Feedermain Contract 5
- Contract 5 provides critical interconnections between the existing and newly constructed Hanlan feedermains at two locations, Little Etobicoke Creek at Burnhamthorpe and Eastgate
- Compound within the Burnhamthorpe Park area north of Burnhamthorpe at the Little Etobicoke Creek
- Construction Period – December 2024 to mid 2026 (or earlier)
- Cawthra Sanitary Sewer Interconnection Project
- This work will construct an interconnect between two sanitary trunk sewers located along the Little Etobicoke Creek and Cawthra
- Compound within the Burnhamthorpe Park area, south of Burnhamthorpe at the Little Etobicoke Creek
- Anticipated Construction Period – Currently mid 2025 to 2027
- Mid Block Crosswalk
- Construction of a signalized cross walk to permit a continuous path for the Applewood Trail System
- Anticipated Construction Period – mid to end 2027
Applewood Trail System
Current State
- The Applewood Hills Trail underpass at Burnhamthorpe Road was damaged during the large rainstorm events this past summer and has been closed by City of Mississauga staff.
- On the trail approaching Burnhamthorpe Road from the south, detour signage is currently in place directing trail users to cross Burnhamthorpe Road at Golden Orchard Drive (the nearest signalized crossing).
- On the trail approaching Burnhamthorpe Road from the north, detour signage is currently in place directing trail users to cross Burnhamthorpe Road at Golden Orchard Drive (the nearest signalized crossing).
Temporary State (2025Q1 to mid 2026)
- On the trail approaching Burnhamthorpe Road from the north, trail users in the near future will find the existing trail interrupted due to a temporary construction compound. To permit semi-continuous access (intermittent full trail closures) to Burnhamthorpe, trial users will encounter a temporary walkway that has recently been constructed which will provide for a temporary access to Burnhamthorpe when its safe to do so. The temporary compound area may be in place until mid 2026, and depending on the activities at the compound, the temporary walkway will provide a safe route through the construction. If activities at the compound do not permit safe passage by the temporary walkway, the walkway south of the trial intersection will be closed and the trail users will be detoured towards Golden Orchard or Lovingston.
- Through discussions with Councillor Fonseca’s office and the City of Mississauga, we are entertaining a constant detour be in place during the entire construction project to RECOMMEND all users of the trail system detour to the neighbouring streets, like the detour that will be enacted when the trail system is closed.
- The temporary walkway is not currently for use and have placed barrels and have taped off the ends to restrict access to the temporary walkway. Once our contractor returns in the new year, the temporary walkway will have a barrier installed along the west side (outer barrier of the compound) and we will be placing some material along the east side when we return after the break. The existing trail is still in full service and maintained in typical fashion over the holiday season.
Maintenance of the Temporary Walkway
- City of Mississauga Parks Operations team will be providing a consistent level of service for the temporary walkway, similar to what the trail system currently receives. The temporary walkway has been built as a 1.8m (6ft) wide platform which is wider than many pedestrian sidewalks in Mississauga and can be easily maintained by the City.
Future Trail System Enhancements
- The mid-block signalized crossing at Burnhamthorpe Road for the trail will be installed by the City immediately following the completion of the Region of Peel’s construction projects situated at the north and south sides of Burnhamthorpe Road. Region and City staff are coordinating their efforts through this process. Current schedule is still to be determined but is projected to be in mid to late 2027.
- The interrupted trail will be reinstated, and the landscaping will be returned to similar state through the Burnhamthorpe Park as the various contracts are finished.
——————————————————————————————————————————————————

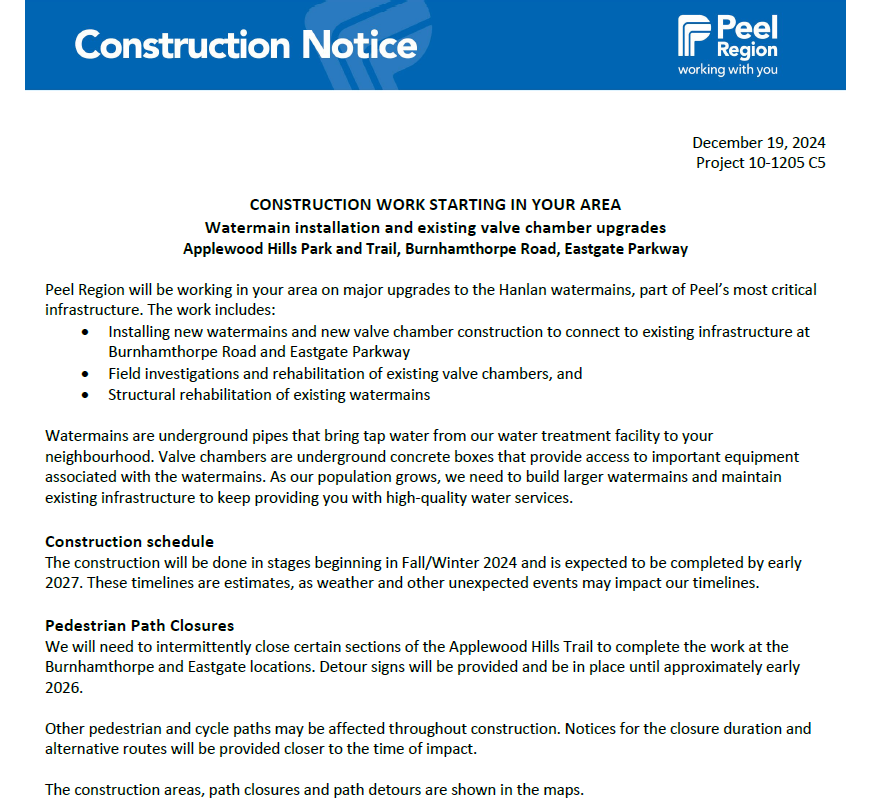

Peel Region will be working in your area on major upgrades to the Hanlan watermains, part of Peel’s most critical infrastructure. The work includes:
- Installing new watermains and new valve chamber construction to connect to existing infrastructure at Burnhamthorpe Road and Eastgate Parkway
- Field investigations and rehabilitation of existing valve chambers, and
- Structural rehabilitation of existing watermains
Watermains are underground pipes that bring tap water from our water treatment facility to your neighbourhood. Valve chambers are underground concrete boxes that provide access to important equipment associated with the watermains. As our population grows, we need to build larger watermains and maintain existing infrastructure to keep providing you with high-quality water services.
Construction Schedule:
The construction will be done in stages beginning in Fall/Winter 2024 and is expected to be completed by early 2027. These timelines are estimates, as weather and other unexpected events may impact our timelines.
Pedestrian Path Closures:
We will need to intermittently close certain sections of the Applewood Hills Trail to complete the work at the Burnhamthorpe and Eastgate locations. Detour signs will be provided and be in place until approximately early 2026.
Other pedestrian and cycle paths may be affected throughout construction. Notices for the closure duration and alternative routes will be provided closer to the time of impact.
The construction areas, path closures and path detours are shown in the maps.
